S.R. 2 & Larrison Boulevard Intersection Improvement in St. Joseph County (Des 2401424, 2401505, 2401506)

This page covers the public hearing and project details for the S.R. 2 at Larrison Boulevard/Strawberry Road proposed improvements in St. Joseph County.

Proposed Improvements to State Road 2 at Larrison Boulevard/Strawberry Road in St. Joseph CountyBy clicking this image, you will be redirected to YouTube to watch a tutorial on how to navigate a diverging diamond.

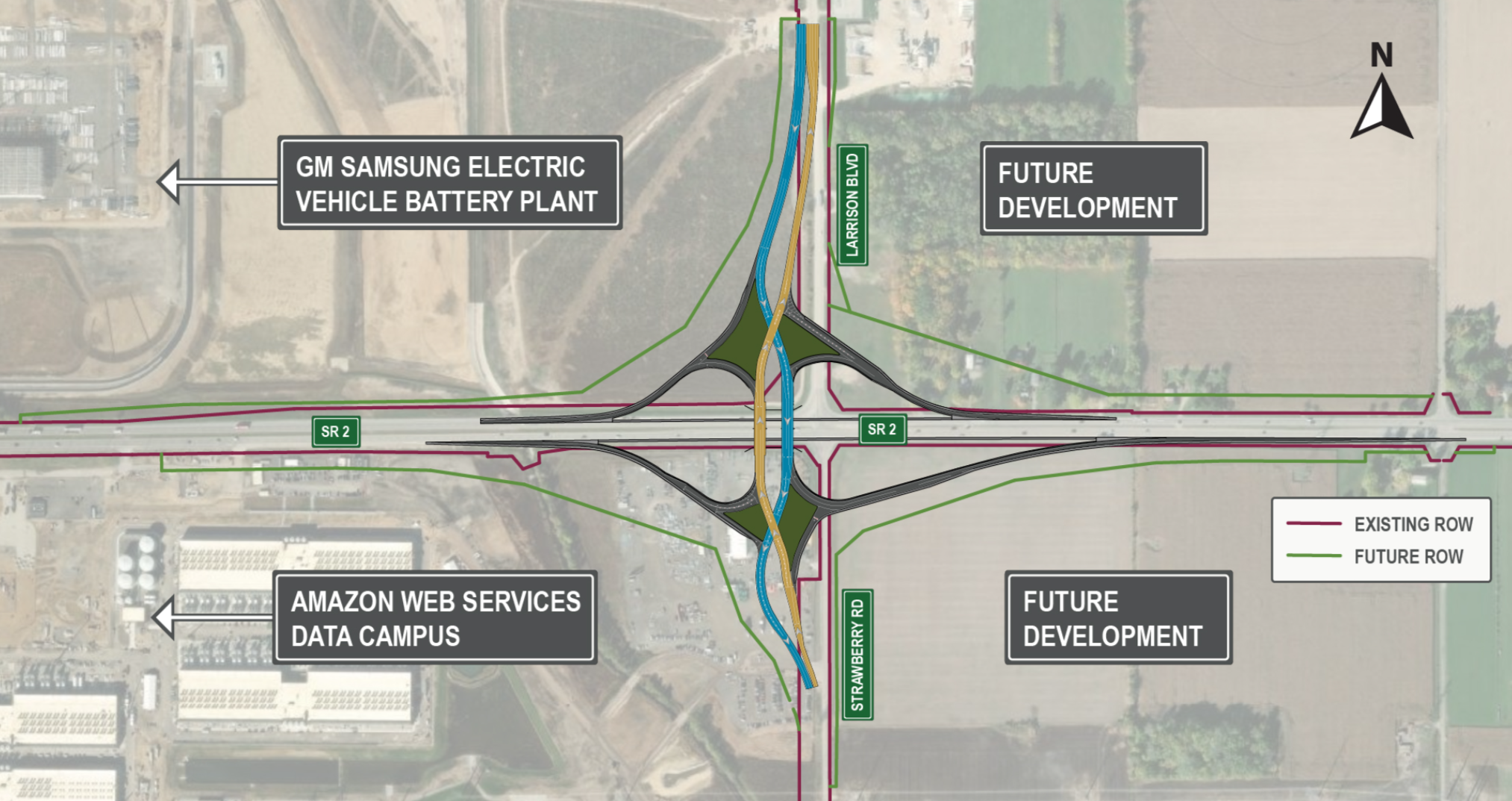

As proposed, the project involves converting the existing two-way stop-controlled intersection to a grade-separated interchange with a design referred to as a diverging diamond. The interchange will include constructing two bridges carrying Larrison Blvd/Strawberry Rd over S.R. 2, four single-lane interchange ramps, widening Larrison Blvd/Strawberry Rd approaching the interchange, and installing traffic signals north and south of S.R. 2 to control traffic on Larrison Blvd/Strawberry Rd when crossing over the diverging diamond interchange. S.R. 2 will remain a four-lane divided highway with two lanes in each direction.

A public hearing was held on March 30, 2026 to offer all interested persons an opportunity to comment on current design plans.

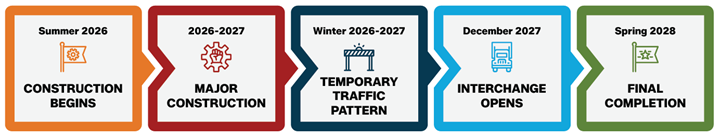

Project schedule for SR 2 at Larrison

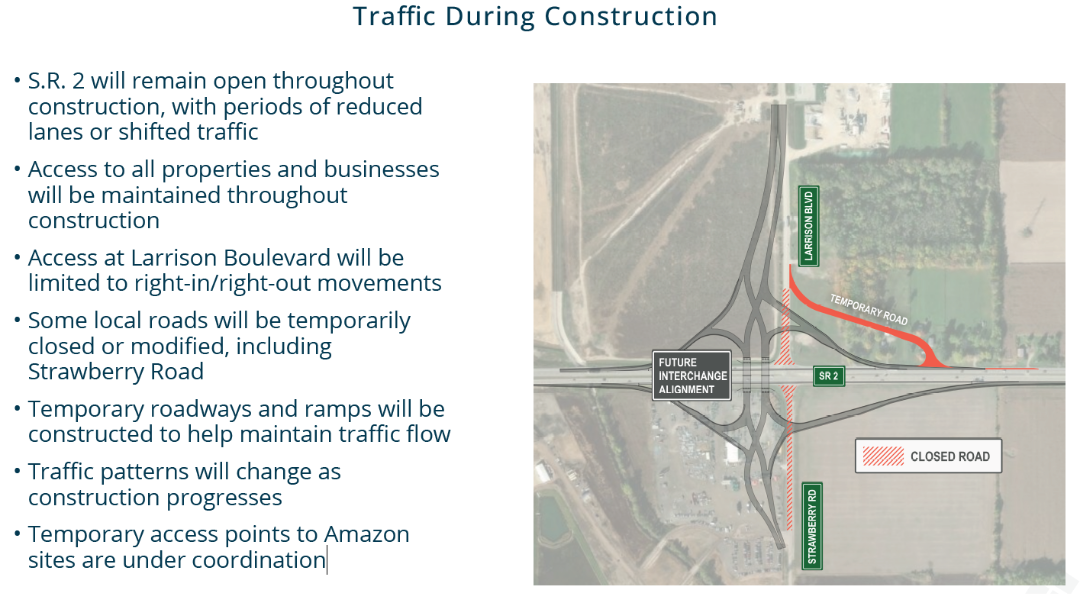

Traffic During Construction

INDOT Graphic of sr 2
